How to Improve Equipment Uptime: 12 Ways to Increase Uptime and Reduce Breakdowns

Ask any maintenance leader in a refinery, a chemical plant or a mine where their uptime goes, and the honest answer is rarely the repair itself. It is the wait before the repair. The hours lost while a fault sits unreported, a permit waits for sign-off, a spare part is tracked down, or a half-finished job is handed to the next shift. This is the insight-to-execution gap, and closing it is the fastest way to improve equipment uptime.

This guide gives you the practical answer. It covers how to calculate equipment uptime, twelve proven ways to increase it and reduce breakdowns, realistic benchmarks by asset type, and the metrics that show whether your efforts are actually working.

What Is Equipment Uptime and How Do You Calculate It?

Equipment uptime is the share of scheduled operating time that an asset is actually running and available to produce. It is the simplest measure of whether a machine is doing its job when the plan calls for it.

You calculate equipment uptime by dividing the hours an asset was actually running by the hours it was scheduled to run, then multiplying by 100 to get a percentage.

Equipment uptime formula

Uptime (%) = (Actual running hours divided by scheduled operating hours) x 100

Here is how that looks with real numbers. A boiler feed pump is scheduled to run 168 hours in a week. Unplanned failures take it out of service for 9 hours. Its uptime for that week works out as shown below.

Input

Value

Scheduled operating hours

168 hours

Unplanned downtime

9 hours

Actual running hours

159 hours

Uptime calculation

(159 / 168) x 100

Uptime result

94.6%



Two things can make the same performance look different from one site to the next, and both are worth naming:

  • Planned maintenance treatment: If one plant counts a planned overhaul as downtime and another leaves it out, the two will report different uptime for identical machines.
  • Idle time: An asset sitting idle because there is no production demand is not down in any way maintenance controls. If idle time is charged against uptime, the number punishes maintenance for a production decision.

Plants need to pick one rule for each and apply it to every site.

12 Ways to Improve Equipment Uptime and Reduce Breakdown

The twelve strategies below are ordered roughly the way a plant should work through them, starting with deciding which assets matter most and ending with learning from every failure. Each one targets a specific point where uptime is commonly lost. You do not have to do all twelve at once. Start where your biggest losses are and build from there.

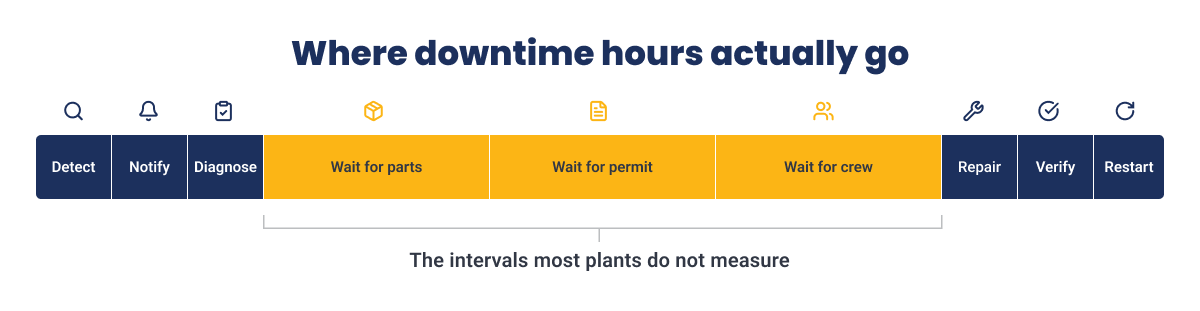

Where downtime hours actually go

1. Rank assets by the cost of an hour of downtime, not by an old criticality label

Start by ranking your assets by what one hour of downtime actually costs in lost production, rather than by a criticality rating set years ago at commissioning. A label tells you an asset matters. A cost figure tells you how important, in tons per day or barrels per day, and lets you compare two assets honestly.

  • The practical test: can your team name the hourly cost of your ten most important assets stopping, without digging through old records to work it out? If not, the ranking is a label, not a number you can act on.
  • Revisit the ranking when the production plan changes. Asset bottlenecks depend on the product mix and season, so last year's priority list may no longer be right.
  • Metrics to watch: Critical-asset maintenance coverage, the share of maintenance hours spent on the production-critical assets that carry today's plan.

2. Shrink detection lag by feeding operator rounds and sensors into one queue

Close the gap between an operator noticing a change on a round and someone who can actually act on it. The common failure is quiet: a reading gets written on a paper round sheet, the sheet gets filed, and nobody spots the trend until the asset stops.

  • Ensure that sensor data and human observation belong in the same queue. When they sit in two systems, you get two watchlists, two priorities, and an alert that nobody owns.
  • Most collected condition data is never acted on. A simple rule keeps it honest: a reading that does not lead to a work order is not monitoring, it is just storage.
  • Moving from paper to digital operator rounds helps here, because an out-of-range reading can raise a work request against the exact equipment on the spot, instead of a note that sits on a clipboard.
  • Metrics to watch: Mean time to detect (MTTD), how quickly problems are caught, along with the share of failures that had an early warning sign nobody acted on.

3. Turn a reported problem into a live work order in minutes, not shifts

Measure the time between a problem being reported and a scheduled, resourced work order existing in your system of record. In many plants this generally occurs when shifts change, and that delay is exactly the gap between seeing a problem and acting on it.

  • Part of the delay is the record itself. Raising a breakdown work order in SAP can take six separate transactions, which is why technicians often do not do it at the machine, and why the record arrives late or never gets created at all.
  • A late record does more than hold up one job. It leaves gaps in the failure history that later reliability decisions depend on, so the plant ends up making calls on incomplete data.
  • Tools such as WorkSmartAI let a technician raise a structured work order from a photo or a short voice prompt, with the equipment identified automatically, and RapidSync keeps that record in sync with SAP or IBM Maximo within minutes even while offline.
  • Metrics to watch: Notification-to-work-order time, the average hours from a problem being reported to a work order being released to the crew.

4. Prove parts readiness before the job reaches the schedule

Make sure the exact parts for a job are picked, staged and confirmed before that job is scheduled, rather than finding out the part is missing when the crew is already at the machine. A part showing as in stock in the system is not the same as a part that is physically ready to install.

  • This is an uptime problem, not just an inventory problem. When a job is pushed because the part was not ready, the asset stays down for a whole planning cycle, not just the few minutes it takes to walk to the storeroom.
  • Treat parts readiness as a checkpoint the job has to pass. If the materials are not confirmed and staged, the job does not go on the schedule yet.
  • Getting parts kitted and staged against the specific work order, supported by spare parts management software, is what makes that checkpoint real rather than a box someone ticks.
  • Metrics to track: Parts availability at the job, how often the right parts are on hand when the crew arrives, along with the job reschedule rate for missing materials.

5. Clear permits and isolations ahead of the job

Treat the time crews spend waiting for a permit or an isolation as downtime you can measure and reduce, not as unavoidable safety paperwork. In asset-intensive industries such as oil, gas, chemical and mining plants, most maintenance work needs a permit before it can begin, so a slow permit process directly holds up the repair and keeps the asset down longer.

  • The fix is to have the permit, the isolation plan and the protective equipment requirements ready and attached to the work order in advance, rather than chasing them on the morning the job is due to start.
  • A digital permit to work software keeps permits and job hazard analyses moving instead of sitting on someone's desk, which is where a large share of permit delay comes from in high-hazard plants.
  • Metrics to track: Permit and isolation wait time, the technician hours lost each week waiting for a permit or an isolation, tracked as its own category of downtime rather than buried inside repair time.

Also, read: What Is an Electronic Permit to Work (ePTW)?

6. Raise schedule compliance and stop churning the frozen schedule

Increase the share of scheduled work that actually gets completed in the week it was planned for. Schedule compliance is one of the most overlooked drivers of uptime, and in many plants only around 60 to 65 percent of planned work gets done on plan.

  • The mechanism is direct. A schedule broken mid-week converts planned work into emergency work, and emergency repairs typically cost three to ten times a planned job.
  • Hold a freeze window as a discipline, not a system setting. Once the weekly schedule is frozen, only a genuine emergency breaks it.
  • Higher schedule compliance raises wrench time, higher  wrench time  closes work faster, and faster closure shortens the downtime window. That chain is what makes schedule compliance pay off.
  • Metrics to track: Schedule compliance and PM ratio, the share of planned work completed on plan, and the PM ratio of planned to reactive work.

7. Decompose MTTR and fix the longest delay

Break mean time to repair (MTTR) into its real intervals: detect, notify, diagnose, wait for parts, wait for permit or isolation, wait for a competent crew, repair, verify, restart. Relying only on mean time to repair hides all of these intervals and tells a maintenance leader very little.

  • In most asset-heavy plants, the hands-on repair is a small part of the total time an asset is down. Most of it is waiting. A team focused only on working faster is fixing the smallest part of the problem.
  • MTTR is usually easier to influence than the time between failures, so for many plants it is the better place to start.
  • The stages a maintenance team can actually control are detection, reporting, and parts and permit readiness, which are the same things covered by the strategies above.
  • Metrics to track: MTTR by interval, mean time to repair broken out by stage, rather than as a single number.

8. Put the work instruction at the asset, not in a binder

Give technicians the correct, up-to-date work instruction at the machine, instead of leaving it in a binder in the planner's office or existing only in the memory of a technician who is about to retire. When the right instructions are available at the point of work, jobs get done right the first time and rework drops.

  • There is a difference between a document and a usable instruction. A usable instruction is step by step, current, and guaranteed to be the latest version at the point of work.
  • Digital work instructions with version control mean a crew is never working from an out-of-date procedure, and the knowledge does not walk out the door when an experienced technician leaves.
  • Metrics to watch: First-time fix rate, the share of jobs done correctly on the first visit, along with the rework rate.

9. Retire preventive maintenance tasks that never find a problem

Look at your preventive maintenance tasks and retire the ones that consistently turn up nothing. This is the one strategy on the list that removes work rather than adding it, and it gives back both technician hours and planned downtime the plant can use elsewhere.

  • Across industry, a meaningful share of preventive maintenance work adds little value, and calendar-based tasks only catch some failures. The sensible response is to remove the tasks that are not earning their place, not just to keep adding more.
  • A task worth reviewing is a preventive job that has generated no follow-up repairs over several cycles.
  • This is about adjusting intervals based on evidence, not about deferring due work. The method is covered in more depth in our guide to preventive maintenance optimization.
  • Metrics to track: PM hours per finding, preventive maintenance hours spent for each problem found, along with the planned downtime those tasks consume.

10. Ensure that the insights from a handover passes on to the next shift to prevent diagnosis from scratch

When a fault is partly diagnosed at the end of a shift, make sure that progress reaches the next crew. When it is handed over verbally or on a whiteboard, the incoming crew re-diagnoses from scratch and the elapsed downtime doubles for no extra work done.

  • Four things need to carry across a handover for it to count: what the symptom is, what has been ruled out, what has been isolated, and what the next step is.
  • A structured, digital shift handover software keeps that detail intact between crews, so the next shift picks up where the last one left off.
  • Metrics to track: Cross-shift resolution time, how much longer faults take to resolve when they span a handover, compared with those handled within one shift.

11. Keep execution working even when offline

Make sure work can be executed and recorded where there is no signal. In intrinsically safe zones, tank farms, underground workings and dead-spot plant areas, offline capability is a necessary requirement, not a convenience.

  • When execution is online only, the technician completes the job and records it hours later from a desk. That delays the record, leaves gaps in labor and failure data, and removes any chance to act on what was found while the asset is still open.
  • Offline execution that stores the work on the device and syncs it once the signal returns, along with device-to-device sharing when the network is down, keeps the record accurate and on time.
  • Metrics to track: Point-of-work capture rate, the share of work records created at the asset versus entered later from a desk.

12. Close the loop with failure coding and root cause analysis

Code every repair with problem, failure and action codes so a repair becomes reliability data rather than a closed ticket. When codes are skipped or inconsistent, the failure history cannot support any later interval or replacement decision.

  • Set a trigger for deeper investigation. When the same asset fails the same way inside a set period, run a structured root cause analysis rather than another quick fix.
  • This strategy comes last in the order but pays back the most over time, because it is what stops the same breakdown from happening again. Many repeat breakdowns trace back to a handful of common causes of equipment failure that good coding makes easy to see.
  • Metrics to track: Repeat failure rate, how often the same asset fails in the same way within a set period.





Whitepaper

Turn these 12 strategies into a working AI plan.

Get the practical blueprint for moving from reactive, disconnected maintenance to continuous, AI-supported execution across your plant.

Download the AI in Maintenance Blueprint

Is Your Uptime Number Actually Good? Availability, OEE and Realistic Benchmarks

Once you can measure uptime, the next question is whether your number is any good. A single percentage does not tell you much on its own, because a lot depends on what you chose to count and on the type of asset you are measuring. This section helps you understand your uptime number properly and set a target that fits your plant.

Uptime, availability and OEE: what each number hides

Uptime, availability and overall equipment effectiveness sound similar but measure different things, and mixing them up is how a slow-running asset can still look healthy on an uptime report. Here is how they compare.

Metric

What it measures

How it is calculated

What it leaves out

Equipment uptime

How much of the scheduled time the asset was running

Running hours / Scheduled operating hours x 100

Speed and quality. A machine running slowly can still show high uptime.

Availability

How much of the time the asset was able to run

Running hours / (Running hours + all downtime) x 100

Whether the asset was actually needed. Idle time can make it look better than it is.

OEE

How much good output the asset produced against its full potential

Availability x Performance x Quality

Nothing on its own, but it needs speed and quality data, not just running hours.



The practical point is that a plant can push uptime up while OEE falls, because uptime says nothing about how fast the asset ran or whether the output was good. If uptime is the only number you report, a machine that runs below its rated speed never shows up as a problem. Maintenance and reliability leaders should watch all three, not just the one that is easiest to report.

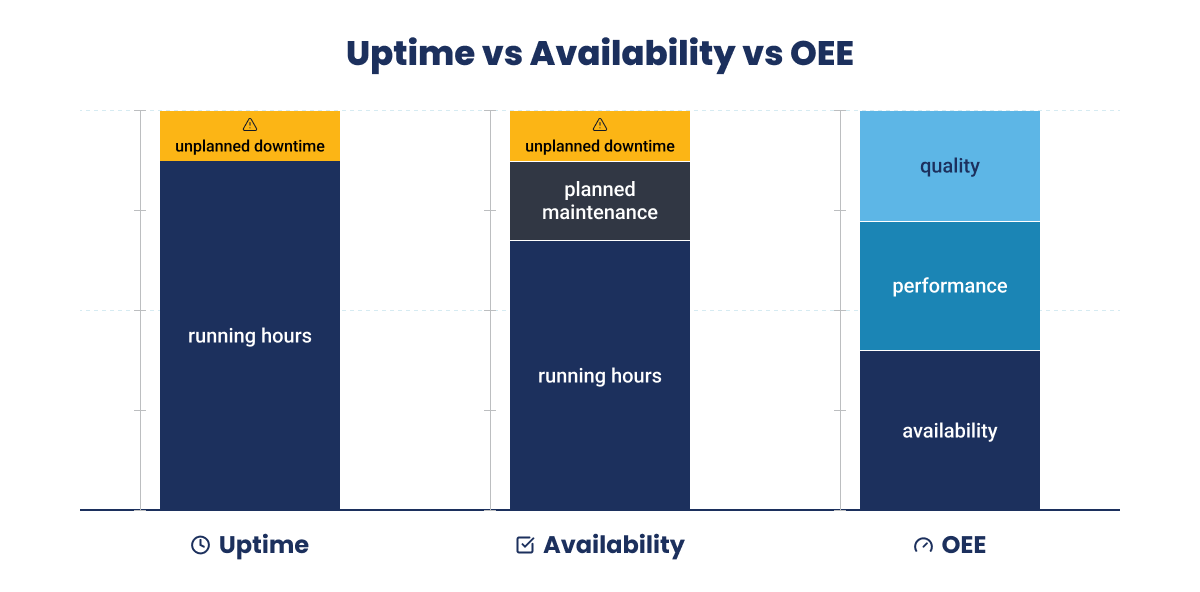

Uptime vs Availability vs OEE

Realistic uptime benchmarks by asset type

There is no single good uptime number that fits every asset. A sensible target depends on the type of equipment, whether it has backup, and whether it sits on the critical path for production. The ranges below are directional, drawn from reliability practice and the approach set out in ISO 14224, and are meant as a starting point rather than fixed targets.

Asset type or setup

Typical availability range

What usually limits it

Where the gains usually come from

Rotating equipment running continuously (pumps, compressors, fans, gearboxes)

High 90s in a strong program

Seal, bearing and lubrication failures, and long lead times on parts

Condition monitoring plus confirmed parts readiness

Fixed process equipment (heat exchangers, vessels, columns)

Very high when inspected on time

Fouling and corrosion found too late

Operator rounds plus discipline on inspection intervals

A single production line with no backup equipment

Lower, with little room for error

One failure stops production outright

Priority-based preventive maintenance and staged spares

A line with backup or parallel equipment

Higher, with more room to recover

A backup unit that has quietly failed

Testing the backup unit, not just the one in service

Mobile or mining fleet

Mid-to-high 80s is common

Hard operating conditions, travel to the repair, and remote parts

On-board condition data plus faster field execution



Be careful with the 99.9 percent uptime figures you see quoted online. Those come from IT and website-monitoring sources and describe systems with instant automatic backup, which a single compressor does not have. Set your target from your own asset and its backup, using ISO 14224 as a guide.

The KPIs That Prove Uptime Actually Improved

Uptime is a result, not something you control directly. A plant that reports only uptime cannot explain why the number went up or down. The eight KPIs below are the measures that actually drive uptime, each with how it is calculated and the direction you want it to move.

KPI

How it is calculated

What it tells you that uptime does not

Target direction

MTBF (mean time between failures)

Total operating time / Number of failures

How often the asset fails, not just how long it ran

Higher

MTTR (mean time to repair)

Total repair time / Number of repairs

How fast you recover, and where the time goes when broken out by stage

Lower

PM compliance

PM tasks completed on time / PM tasks due x 100

Whether planned work is actually happening on plan

Toward 90% and steady

Schedule compliance

Scheduled tasks completed in the week / Tasks scheduled x 100

How much of the weekly plan survives the week

Toward 85%, from a common 60-65%

Planned vs reactive ratio

Planned maintenance hours / Total maintenance hours x 100

How reactive the plant still is

Rising toward 80% planned

Wrench time

Hands-on tool time / Total shift time x 100

How much of the shift is lost to waiting and travel

Toward 50%+, from a common 25-35%

First-time fix rate

Jobs fixed on the first visit / Total jobs x 100

Whether the fix held, not just that it happened

Higher

Maintenance backlog

Total ready work hours / Weekly crew capacity hours

Whether maintenance is keeping up with demand

A healthy band is often 4-6 crew-weeks


If your plant tracks none of these today, start with three: schedule compliance, MTTR broken out by stage, and maintenance backlog in crew-weeks. Those three explain most of what moves uptime.

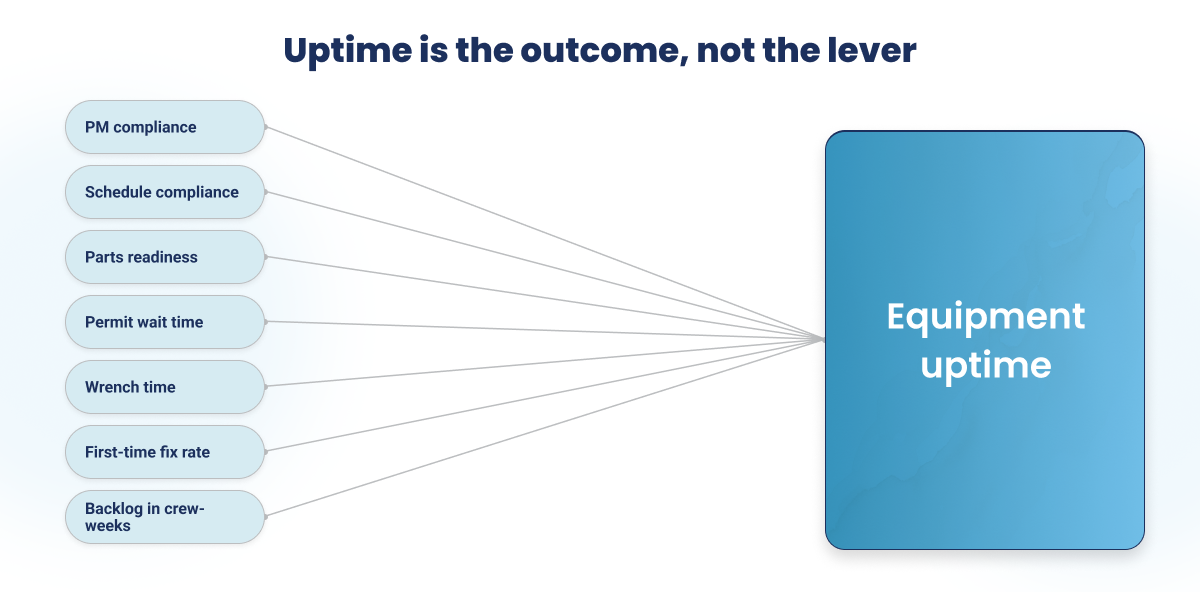

Uptime is the outcome, not the lever



Uptime and Plant Bottlenecks: Where Higher Uptime Pays Back, and Where It Does Not

Improving uptime only pays off when the effort lands on the right asset and the number is real. Put time and money into raising uptime on a machine that is not limiting production, and you get no extra output for it. The asset that sets the pace for the whole plant is the bottleneck, and that is where uptime work returns the most.

1. Find the bottleneck before you invest in uptime

Find the bottleneck first: which asset's stoppage actually shows up in the plant's daily output number, and which asset's stoppage is absorbed by buffer, backup equipment or downstream slack. Spend uptime effort on the first kind.

  • The answer changes over time, because the bottleneck moves with product mix, the production plan and the season.
  • A common mistake is to rank assets by how often they break down, which points effort at the machines that fail most, rather than by how much output is lost, which points effort at the machines that matter most.
  • Metrics to track: Production lost per asset, the output units lost per asset over a period, rather than downtime hours per asset.

2. When the bottleneck is the maintenance process, not the asset

Sometimes every asset is available and output still falls short. When that happens, the thing holding the plant back is usually not a machine at all. It is technician capacity, parts supply, permit throughput or approval queues, and the strategies above should then be applied in a different order.

  • The signal is clear. When your assets are available but the backlog keeps growing in crew-weeks, the bottleneck is maintenance capacity, not asset reliability.
  • Manual handoffs between systems slow the whole maintenance process down, which ties straight back to the strategies on notifications, parts readiness and permits.
  • Metrics to track: Backlog in crew-weeks, the ready work backlog measured in crew-weeks, along with standard hours completed per crew each week.

3. Three ways an uptime number can look better than it is

The fastest way to raise reported uptime is to defer planned maintenance, and it works for a quarter or two before the deferred work returns as unplanned downtime. A higher number is not always a better outcome.

  • Deferring planned maintenance borrows uptime from next quarter and pays it back as a bigger turnaround.
  • Running an asset there is no production demand for produces uptime and no output.
  • Running a machine below its rated speed to avoid stopping trades output for availability, and shows up in OEE rather than uptime.

4. What maintenance controls, and what it does not

It helps everyone to be clear about the boundary here. Maintenance owns detection, response time, readiness and the quality of the repair. Maintenance does not own the production plan, how often lines change over, feedstock quality, how the plant is operated, or capital decisions on replacing equipment.

When a maintenance team is held to an uptime target it only partly controls, it will tend to manage the number rather than the asset, which is how the traps above take hold. The bigger picture matters too: a large share of installed industrial capacity sits idle at any given time, which is a reminder that uptime is a plant-wide question, not one the maintenance team can answer alone.

Whitepaper

Close the insight-to-execution gap on your plant floor.

Most lost uptime hides in the insight-to-execution gap, the hours between a problem being seen in the plant and tracked, resourced work existing in your system of record. See how a frontline execution platform closes that gap and turns waiting time into recovered uptime.

Download Guide

How Improving Equipment Uptime Reduces Maintenance Cost

Higher uptime lowers maintenance cost because it shifts work out of the expensive, reactive column and into the cost effective, planned one. Reactive maintenance, also called breakdown maintenance, is work carried out after a failure, and it runs on overtime, rush parts, expedited freight and contractor cover. Emergency repairs of this kind typically cost roughly three to ten times a comparable planned job. The same repair costs far less when it is scheduled than when it is an emergency, so the plants that raise uptime usually cut cost at the same time.

The scale of this is well documented. Across industries, the Information Technology Intelligence Consulting (ITIC) 2024 survey put the cost of a single hour of downtime above USD 300,000 for more than 90 percent of mid-size and large enterprises, with 41 percent reporting that an hour costs between USD 1 million and more than USD 5 million. Studies of maintenance programs, including the U.S. Department of Energy's Operations and Maintenance Best Practices Guide, consistently find that reactive maintenance costs far more than planned maintenance, which is why the cost of unplanned downtime sits at the heart of the maintenance cost problem.

The table below shows how each gain in uptime feeds through to lower cost.

What higher uptime changes

Why maintenance cost drops

Fewer breakdowns, more planned work

Planned jobs avoid overtime and rush charges

Fewer emergency call-outs

Less reliance on contractors and premium labour

Fewer rush part orders

Lower expedited freight and less emergency stock

Damage caught earlier

A fault fixed early costs less than a full failure

Steadier production

Fewer missed shipments and penalty costs


The result is a lower total maintenance cost, often measured as maintenance spend against the replacement value of the assets.

Indorama Ventures: An Uptime-Led Program That Cut Maintenance Cost

Indorama Ventures shows what this looks like in practice. The global chemical manufacturer ran its Port Neches, Texas site with a reactive maintenance culture: a planned-to-reactive ratio below 50 percent, a 24-week maintenance backlog, and heavy use of contractors and overtime, even with SAP PM and IBM Maximo already in place. By moving technicians onto mobile execution, improving parts readiness, and prioritising the work that protected the most output, the site raised uptime and completed more planned work without adding people. The cost results followed within twelve months.

Metric

Before

After

Planned-to-reactive ratio

45%

80%

Maintenance backlog

24 weeks

10 weeks

Contractor headcount

140

87 (38% lower)

Overtime

24%

12% (halved)

Parts availability at the job

55%

95%


Together these changes contributed to USD 50 million in maintenance savings. The savings did not come from doing more maintenance. They came from completing the right work more efficiently: fewer breakdowns to chase, fewer contractor hours, less overtime, and less rework.

Case Study

See how Indorama Ventures unlocked 50 million dollars in maintenance savings.

Read the full case study on how a connected worker approach cut the backlog from 24 weeks to 10, halved overtime, and moved the plant from reactive repairs to planned maintenance.

Download Case Study

How Innovapptive Helps Asset-Heavy Plants Improve Equipment Uptime

Look back over the twelve strategies and a pattern stands out. Most of them are not really machine problems. They are handoff problems: a reading that never reaches a planner, a permit that waits for sign-off, a part that was not staged, a diagnosis lost at shift change. Each one is a break between a person in the plant and the system that runs it, and that break is where uptime leaks away.

Innovapptive is an industrial execution platform and connected worker platform built to close those gaps. Its mobile maintenance software, iMaintenance, gives technicians prioritised work on a mobile device with the work instructions, permits, forms and parts attached, and sends every action back to the system of record without duplicate data entry. It works alongside your SAP, IBM Maximo or Oracle system rather than replacing it, so your ERP stays the source of truth and there is no rip-and-replace project.



Two capabilities do most of the heavy lifting. WorkSmartAI lets a technician raise a structured work order from a photo or a prompt in seconds, with the equipment identified for them, so the six SAP transactions behind a breakdown work order collapse into a single screen. RapidSync keeps the field and the system of record in step with two-way sync in under five minutes, even in low-signal areas, so records arrive on time and the data stays clean. Together they close the gap between seeing a problem and acting on it, which is where most uptime is won or lost.

Demo

See the loop close on your own system of record.

Get a working walkthrough of a problem in the plant becoming tracked, resourced work in SAP or IBM Maximo in minutes, mapped to your assets, your permit types and your existing setup.

Talk To Our Experts

Frequently Asked Questions

There is no single figure that fits every plant. Rotating equipment running continuously in a strong maintenance program often reaches the high 90s, while a single line with no backup is held to a lower and less flexible standard. The 99.9 percent uptime figures often quoted online come from IT systems with instant automatic backup and do not apply to process equipment.


 It is best understood as a result. Uptime is produced by KPIs you can act on directly, such as schedule compliance, MTTR and parts readiness. If you want to move uptime, you manage those measures, and uptime follows.

Uptime is the share of scheduled operating time an asset is actually running. Downtime is the rest of that time. Downtime splits into planned, when the asset is deliberately taken out for maintenance, and unplanned, when it stops on its own. Improving uptime is mostly about reducing unplanned downtime.

For most plants, MTTR. The time to repair is usually easier to influence than the time between failures, and much of it is waiting time for parts, permits and crews rather than the repair itself. Breaking MTTR into stages and reducing the longest wait is often the fastest route to higher uptime.

 Not on its own. A system of record schedules and stores the work, but uptime improves when the work actually gets done at the machine, on time, with the right parts and permits in place. That is a question of execution on the shop floor, which sits on top of the system of record rather than inside it. This is exactly where Innovapptive helps, by closing the gap between the system of record and the work done at the asset.

Usually, yes, up to a point. Better detection, readiness, scheduling and repair quality raise uptime on ageing assets without capital spend. Replacement becomes the better option only when an asset's failure rate reflects genuine end-of-life wear.

It depends on the strategy. Detection, notification and parts-readiness improvements can raise uptime within weeks. Changes that depend on building up failure data, such as adjusting maintenance intervals and improving reliability practices, take a few quarters. Starting with the faster wins builds momentum.

The common approach is to prove the strategies and the KPIs at one site first, then reuse that setup across the other plants rather than rebuilding it each time. Solutions provided by Innovapptive act as an execution platform sitting on top of the existing SAP or Maximo landscape, making each additional plant a rollout of a proven template rather than a fresh ERP project.

Innovapptive - Connected Worker

Unlock Margins Hidden in your Maintenance

Watch how leading manufacturers improve OEE, increase PM compliance, and reduce downtime through connected execution.
